Archived Web Page - Draft for Public Consultation GD-360: Guidance for Life Management of Nuclear Power Plants
Archived information
Archived information is provided for reference, research or recordkeeping purposes. It is not subject to the Government of Canada Web Standards and has not been altered or updated since it was archived. Please contact us to request a format other than those available.
Preface
Nuclear power plants (NPPs) in Canada are subject to the ongoing regulatory oversight of the Canadian Nuclear Safety Commission (CNSC) to ensure that their operation does not pose unreasonable risk to health, safety, security and the environment, and conforms to Canada’s international obligations regarding the peaceful use of nuclear energy.
GD-360 contains guidance information to assist licensees in meeting the requirements of regulatory document RD-360 version 2, Life Management of Nuclear Power Plants (draft) [1] which describes the regulatory requirements for the long-term operation of an NPP and for the end of its operation.
Long-term operation of an NPP is the operation beyond the assumed design life of the plant. GD-360 provides guidance for the activities required to support the continued operation of an NPP up to its permanent shutdown and activities to support long-term operation.
The end of operation is the final, permanent shutdown of an NPP’s reactor operation. GD-360 provides guidance regarding the activities during the transition period from reactor unit shutdown and safe state of storage until the NPP enters the decommissioning phase.
Other health and safety, environmental and nuclear security considerations may dictate adherence to additional requirements. It is the responsibility of the licensee to identify any other applicable legislation or standards.
Table of Contents
2.2.2 Communication protocol for timelines and deliverables
2.2.3 Statement of licensing basis at the time of initiating the ISR
2.2.4 Safety and control area reviews
2.2.5 List of modern codes, standards and practices
2.2.6 Identification and disposition of findings
2.2.7 Risk management decision making process
2.3.2 Human performance management
2.3.8 Conventional health and safety
2.3.9 Environmental protection
2.3.10 Emergency management and fire protection
2.3.14 Packaging and transport
Appendix A: Life Management of Nuclear Power Plants
Appendix B: Technical Content Guidelines: Sufficiency Checks
1.0 Introduction
As a nuclear power plant (NPP) approaches the end of its assumed design life, the licensee implements the required steps and measures for extending or ending its operation.
Long-term operation (LTO) is the operation beyond the assumed design life of the NPP, which has been justified by the results of an integrated safety review (ISR). The licensee may decide to continue operation of the facility up to its refurbishment or permanent shutdown, or may initiate refurbishment activities to support the period of long-term operation.
End of operation is the final, permanent shut-down of reactor operation of an NPP; the NPP facility remains subject to a power reactor operating licence (PROL) that authorizes activities during the transition period from reactor unit shutdown and safe state of storage until it enters the decommissioning phase.
1.1 Purpose
This document provides guidance regarding activities a licensee must undertake to support long-term operation or to prepare for the end of operation, pursuant to RD-360 version 2, Life Management of Nuclear Power Plants.
1.2 Scope
This document covers activities to be completed during the operating phase of the NPP, under the authorization of a PROL issued by the Commission, and excludes activities that are to be undertaken under the decommissioning licence.
1.3 Relevant regulations
The provisions of the Nuclear Safety and Control Act (NSCA) and regulations made under the NSCA relevant to this guidance document are as follows:
- Subsection 24(4) of the NSCA states that “No licence may be issued, renewed, amended or replaced unless, in the opinion of the Commission, the applicant (a) is qualified to carry on the activity that the licence will authorize the licensee to carry on; and (b) will, in carrying on that activity, make adequate provision for the protection of the environment, the health and safety of persons and the maintenance of national security and measures required to implement international obligations to which Canada has agreed”
- Subsection 24(5) of the NSCA states that “A licence may contain any term or condition that the Commission considers necessary for the purposes of this Act…”
- Section 3 of the General Nuclear Safety and Control Regulations states the general licence application requirements
-
Paragraphs 12(1)(c), (f) and (i) of the
General Nuclear Safety and Control Regulations states that “Every licensee shall
(c) take all reasonable precautions to protect the environment and the health and safety of persons and to maintain security of nuclear facilities and of nuclear substances; …
(f) take all reasonable precautions to control the release of radioactive nuclear substances or hazardous substances within the site of the licensed activity and into the environment as a result of the licensed activity; …
(i) take all necessary measures to facilitate Canada’s compliance with any applicable safeguards agreement; …” -
Sections 3 and 6 of the Class I Nuclear Facilities Regulations state the general licence
application requirements specific to nuclear facilities, and the information that is required in an application
for a nuclear facility operating licence.
Other Acts, regulations, and codes are also applicable to projects to support operation beyond assumed design life. They include the Canadian Environmental Assessment Act (CEAA) [2] and associated regulations [3, 4, 5, 6 and 7] and the Canada Labour Code, Part II, Occupational Health and Safety [8]. Other relevant legislation is listed in the Additional Information section at the end of this guidance document.
1.4 National and international standards
Key principles and elements used in developing this guidance document are consistent with national and international standards, guides, and practices. The document is also consistent with:
- IAEA, Safety Reports Series No. 57, Safe Long Term Operation of Nuclear Power Plants, 2008 [9]
- IAEA, Safety Standards Series No. NS-G-2.10, Periodic Safety Review of Nuclear Power Plants - Safety Guide, 2003 [10]
2.0 Long-term Operation
Long-term operation may require the repair or refurbishment of major components, or substantial modifications to the plant, or both. The need for refurbishment will be largely dictated by the proposed period of LTO. The licensee then prepares for an integrated safety review (ISR) and the resulting integrated implementation plan (IIP). Modifications and upgrades described in the IIP for the safe operation of the facility are commensurate to the scope of the review performed and the proposed period of LTO. Once the ISR is completed and the IIP established, the licensee submits either a continued operation plan or a detailed refurbishment project execution plan including return to commercial operation considerations.
In multi-unit stations, different plans can to be applied to each unit. For example, if the licensee decides to refurbish a multi-unit station it may plan for a staggered refurbishment of each unit instead of a single continuous outage of all units at once. In this case, the plan would require considerations for both continued operation and refurbishment.
The work required in the IIP may constitute a project under the Canadian Environmental Assessment Act and be subject to an environmental assessment (EA). There is flexibility in the order in which the EA and the ISR are conducted. Information to assist the licensee in developing the project description is provided in the Canadian Environmental Assessment Agency’s publication, Preparing Project Descriptions under the Canadian Environmental Assessment Act [11].
The activities the licensee must undertake for LTO include:
- conducting the ISR
- developing the IIP
- developing and implementing the continued operation plan
- developing and implementing the refurbishment and project execution plan
2.1 Integrated safety review
The ISR is a project that includes the following activities:
- preparing the ISR basis document
- conducting the safety and control area (SCA) reviews
- performing the global assessment
- preparing the ISR final report
The results are used to establish corrective actions and safety improvements to be included in the IIP. If an extended outage for refurbishment is necessary then a refurbishment and project execution plan is also required.
The licensee should apply the principles of IAEA Safety Report No 57, Safe Long Term Operation of Nuclear Power Plants, and IAEA Safety Standard No.NS-G-2.10 Periodic Safety Review of Nuclear Power Plants, for completing the ISR for LTO.
International experience has demonstrated that licensees spend considerable time and effort to complete an ISR. The benchmark for time and effort is the conduct of a periodic safety review as described in IAEA NS-G-2.10. The licensee should plan accordingly and begin discussions with the CNSC to ensure expectations are clear and to manage project risks.
2.2 Integrated safety review basis document
The first deliverable for the ISR project is the ISR basis document, which sets out the scope and methodology for the conduct of the ISR. The basis document describes the general terms of the ISR project. To ensure the licensee and regulator have the same expectations for the scope and results of the project, the licensee should prepare and submit the basis document to the CNSC for review prior to any work on the SCA reviews.
A high level project plan should be laid out in the ISR basis document and the following should be established:
- details of project organization
- an achievable schedule highlighting major milestones
- the identification of key project members
- identification and qualifications of the contractors and vendors used
- a list of applicable outputs to the process
In some cases, the basis document will require revision. As part of the basis document, the licensee should prepare a method for proposing, tracking and documenting any changes. Additionally, guidelines on the type of changes that would require the basis document to be revised should be provided.
2.2.1 Scope
The basis document describes the scope of the reviews to be carried out as part of the ISR. To establish a common understanding of what is being reviewed, the basis document identifies facilities; structures, systems and components (SSC); and the time period covered by the review. The type of LTO (with or without refurbishment) will dictate the breadth of scope required.
The proposed period of LTO can span from a minimum of ten years, to a period comparable to the original assumed design life of the plant. When scoping the ISR, the licensee should be conservative and scope several years beyond the proposed LTO period; if the decision is made to continue operating beyond the proposed LTO period, the preparatory work is in place to identify upgrades and modifications required to continue safe operation.
2.2.2 Communication protocol for timelines and deliverables
At the outset of the ISR, an appropriate protocol should be established between the licensee and the CNSC. The licensee should provide details to address the administrative process for submissions and management of deliverables. This protocol applies to the entire project. The protocol should facilitate adherence to schedules and ensure timely submissions of complete and comprehensive information.
This protocol should facilitate meeting the requirements of all applicable regulations and RD-360, and should address the following four key items:
- identification of points of contact for communication
- specific schedules or timeframes for planned activities
- mechanism for dispute resolution
- process for controlling changes to the agreed protocol
2.2.3 Statement of licensing basis at the time of initiating the ISR
No further guidance is needed at this time.
2.2.4 Safety and control area reviews
The method that will be applied in the SCA reviews should be described in the basis document to show how the licensee plans to achieve the objectives of each SCA. The type of review (clause by clause, high-level) applied to each review element should be listed. The method of addressing interdependencies on common services and site-wide issues should also be described.
2.2.5 List of modern codes, standards and practices
An integral element of the ISR is the comparison of current plant state to modern codes and standards used in NPPs. An agreed upon code effective date and a list of codes and standards to be applied is established prior to any work being carried out. This ensures a common and consistent expectation for the reviews.
Codes and standards should be selected taking into consideration the CNSC’s regulatory framework philosophy, as well as current international practice, relevant research or new findings, any relevant operation experience, and any CNSC regulatory documents. Primary consideration for selection of standards should rest with those referenced in licenses or other regulatory documents. IAEA documents and other appropriate international standards should also be considered. If an appropriate Canadian standard is not available, the licensee should propose a reasonable substitute.
A list of common operational standards, methods and industrial best practices should be established that indicates things to be considered in the performance of the reviews.
2.2.6 Identification and disposition of findings
As the SCA reviews and global assessment are carried out, findings will be identified. The licensee should propose a method for identifying, categorizing, ranking risk, and addressing any such findings. The rationale behind the categorization of all findings should be justified by the licensee using technical arguments and supporting evidence. Priority is given to findings that do not conform to the licensing or design basis and these findings are addressed as quickly as practicable.
2.2.7 Risk management decision making process
A list of proposed corrective actions should be submitted to CNSC for acceptance. Typically, the licensee will be able to make a selection between several different methods of dispositioning findings. During the development of the corrective actions, the licensee should decide how to address and resolve the findings of the ISR.
The licensee’s process for decision making should be submitted to the CNSC for review. This process may include risk informed decision-making process, cost-benefit analysis, deterministic analysis and professional judgment. This decision-making process is applied throughout the ISR and should be clearly described in the basis document.
2.2.8 Global assessment
The global assessment is an evaluation of the overall risk associated to the NPP. To carry out the review, the licensee should use a group of non-biased specialists (i.e., people who were not directly involved in performing the SCA reviews) with sufficient expertise in the subject matter. The team should review the findings of the SCA reviews and provide an analysis of any interface issues between the SCA reviews and between any specific deviations. From this work, the licensee should be able to present an assessment of the overall risk of the NPP, including the assessment of interface issues and the risk associated with deviations identified in the ISR. The results of the global assessment should also address the extent to which the following requirements are fulfilled: safety goals and limits; defence in depth; and other fundamental safety methods.
The licensee should describe the method applied in performing the global assessment and the method used to make the risk assessments for the findings, as well as the overall risk judgment of acceptability of LTO.
If the licensee proposes to apply an accepted cost-benefit analysis approach to resolve a gap or a group of gaps, develop a corrective action, implement a safety improvement, or any combination thereof, the global assessment methodology can be used to evaluate the cost-effectiveness of the outcomes.
2.2.9 Management system applied to the ISR
The licensee should outline the management system applied in the performance of the ISR. The licensee should ensure:
- ISR review team is qualified to carry out the review
- provisions have been made for independent review of work done, both in terms of review processes and safety documentation
- data and information controls are in place to ensure that input data is used consistently across the review
- requirements for the preparation and verification of documentation are met
- results are recorded in a systematic and auditable manner; for example, when assessing against modern codes, ensure that a comparison is performed between a code and the as-built design instead of a code-to-code comparison
2.2.10 Change control
During the period between the acceptance of the ISR basis document and the start of the refurbishment activities, the codes and standards identified in the basis document may be revised or new ones may come into effect. The licensee should outline the process that will be used to address new or current revisions of codes and standards. The code effective date should be used to disposition any findings. The process should describe the methodology for assessing the safety significance of the findings.
The decision to proceed with LTO of an NPP is determined mainly by economic considerations associated with the ISR outcomes. The licensee should outline the process for communicating these changes to the CNSC. Through this process, the licensee should notify the CNSC of the change itself and of any significant implications, such as changes to the schedule, scope or processes.
2.3 Safety and control area reviews
The following sections describe the expected content of each SCA review. The licensee should carry out the SCA reviews after CNSC staff has accepted the ISR basis document. Appendix C lists the SCA and the topics to be considered for each area. Continuous improvement is an important aspect of each SCA review, so the licensee should develop initiatives for this in each review and describe the benefits to existing practices.
To ensure the reviews are consistent, the licensee should refer to Appendix B to verify that the documentation is adequately prepared and provides the required information. It is recommended that the licensee ensures that the scope of each review addresses its own requirements, and the requirements of any related SCA as applicable.
The safety and control area reviews are carried out by the licensee, who assesses the actual state of the nuclear facility against modern expectations rather than comparing old and new editions of the codes, standards and practices.
2.3.1 Management system
The review should confirm the management system’s organizational arrangements, processes, resources and plans are valid and effective to achieve the business objectives and strategies for long-term operation or end of operation, and should make adjustments as appropriate.
The review should further confirm the implementation of a management system in accordance with CSA N286 Management System Requirements for Nuclear Power Plants [13] which identifies principles and generic requirements of the management system.
Through implementation of CSA N286 and other management systems (ISO 14001 [14], OHSAS 18001 [15], etc.), the review should explore further opportunities to integrate its processes for managing the business and the actions necessary to satisfy business requirements.
2.3.1.1 Organizational performance
The organizational performance review area considers the influence that leadership, management, culture processes, and policies can have on the safety performance of licensees. This review area addresses:
- safety programs
- safety culture
- contractor management
The management system should integrate safety management into general management. Safety culture is a subset of organizational culture and can be assessed to determine the extent to which there are healthy attitudes towards risk and safety. Although safety culture itself is difficult to measure, by promoting safety culture, a licensee is able to monitor organizational health and intervene where necessary. The CNSC considers the following elements to be crucial for a strong safety culture:
- safety is a clearly recognized value of the organization
- it is clear who is accountable for safety
- safety is integral to all activities of the organization
- there is a safety leadership process
- the safety culture is learning driven
- a safety conscious work environment is evident and supported
Contractor management is included within the review area of organizational performance, as safe performance is a requirement of all workers, including contractors.
The review of the safety program and its implementation should include:
- documentation demonstrating effective application of the safety programs
- maintenance of worker competency through a systematic approach to training
The review of the program and implementation of safety culture should confirm:
- process to assess safety culture is adequate
- level of effort and expertise is appropriate
- safety culture assessments are carried out on a regular basis
- effective use of safety culture assessment results
- progress tracking
- corrective action process is effective
- disposition of actions from the CSNC before licence renewal and after major events
For contractor management, the review should confirm:
- effective prequalification and selection process
- monitoring and maintenance of staffing levels
- appropriate training for contractors
- effective work planning and integration of work by licensees and contractors
- effective supervision of contractor staff safety
- monitoring and controlling contractors hours of work
- contractor procedures that are fit for purpose
2.3.2 Human performance management
Licensees are expected to develop and implement a program that continuously monitors and improves human performance, identifies human performance weaknesses, and reduces the likelihood of human-performance related causes and root causes of nuclear safety events.
Human performance programs for a facility should be developed, reviewed for effectiveness and updated continuously, from the construction through to decommissioning of nuclear facilities.
The review should confirm that the human performance programs:
-
are a core management consideration
- are adequately resourced
- human performance is addressed for all stages of the system lifecycle, for all facility areas
-
reflect currently accepted industrial good practice
- good industry practices are followed
- lessons learned from other high hazard industries are applied as needed
- definitions of human factors and human performance are reviewed to ensure their acceptability
- address and integrate the range of human factors that influence human performance
The following elements should be reviewed to ensure there is an effective interface between them:
- provision of qualified staff
- recruitment
- certification and training
- staffing
- minimum shift complement
- fitness for duty
- hours of work
- fatigue management
- reduction of human error
- human factors in design
- procedures development
- procedural adherence
- work protection and work permit systems
- shift turnover
- pre- and post-job briefings
- organizational support for safe work activities
- human actions in safety analysis
- organizational performance and safety culture
- continuous improvement of human performance
The program should ensure that the organization supports safe work activities, and human performance information and activities are effectively integrated. The licensee should support the human performance program by ensuring the following:
- implementation by suitably qualified staff
- a common understanding of human performance
- expectations that are clearly defined, communicated and understood by all staff
2.3.2.1 Procedures
Procedures should be technically accurate, comprehensive, clear and concise, and should contain adequate information and direction for staff (for example, operators, maintainers or testers) to complete their tasks. They should be unambiguous and relevant to the current plant configuration; this ensures that procedures fit the purpose for which they are intended.
Information from task analyses should be used to develop the various technical steps in the procedure, and the format and organization of procedures are to be based on a writer’s guide that considers usability of the procedures. Procedures need to be verified for technical accuracy, and validated by a walk-through of the task(s) with representative end users, to ensure that the procedures can be carried out as intended and that the technical requirements of the tasks can be achieved.
The review of the process to develop and implement procedures should address the following:
- availability of procedures for routine, non-routine, and emergency operations
- procedures content based upon tasks, and analysis of the tasks
- competent procedure writers
- writer’s guide and usability requirements
- an effective process for the verification and validation of procedures
- an effective process for procedure review and procedural revisions
- procedures developed in a timely manner
- control of procedures documents
- training of personnel to use procedures
The review of the process for ensuring procedural compliance should include:
- clearly defined expectations of procedure use
- availability of the most up-to-date version of the procedures
- effective mechanisms for enforcing procedure use and monitoring use and deviation
- clearly defined process for managing any deviations from a procedure
2.3.2.2 Work organization and job design
Work organization and job design relates to the organization and provision of adequate staff, as well as the organization and allocation of work assigned to staff, in order to ensure that work related goals are achieved in a safe manner. G-323, Ensuring the Presence of Sufficient Qualified Staff at Class I Nuclear Facilities - Minimum Staff Complement [16] describes the CNSC’s expectations for ensuring the presence of a sufficient number of qualified staff at Class I nuclear facilities. G-278, Human Factors Verification and Validation Plans [17] describes the CNSC’s expectations for validation of adequate staffing.
The review of the work organization and provision of adequate staffing should include:
- defined and maintained staffing levels based on organizational requirements for meeting safety goals
- an auditable process in place to ensure staffing changes will not negatively impact safety goals
- an effective change management process to support staffing changes
Implementation of the process to manage the minimum shift complement should include:
- systematic analysis of facility requirements
- minimum staff complement (MSC) numbers determined for positions which may impact upon safety during an event
- validation of MSC according to G-323
- an effective plan to address MSC issues during a pandemic
- monitoring of MSC at all times
- keeping records to demonstrate that MSC is met for every shift
- reporting of MSC violations to the CNSC
- requesting consent from the CNSC for MSC changes
- periodic review of MSC program
2.3.2.3 Fitness for duty
The objective of this portion of the review is to confirm that workers who carry out tasks that could impact safety are fit for duty. An evaluation of a worker’s fitness for duty can be conducted by considering components of the program, circumstances of duty and the degree of fitness of workers. The review should describe the method used to assess the degree of worker fitness, ranging from fit to unfit, and may be classified as temporary or permanent.
In evaluating the fitness for duty program, the following components should be reviewed
- medical assessments
- psychological assessments
- hours of work
- fatigue management
- substance and biochemical assessments
The fitness for duty program should consider different circumstances of worker duty, including:
- pre-placement
- periodic
- for-cause (observed behaviour)
- post-incident
- employee assistance program
- return to work
- job transfer
- continuing disability
2.3.3 Operating performance
The licensee should have a system for keeping records of all incidents and evaluating their safety significance. In addition, records of plant operation, maintenance, testing, inspection, replacement and modifications should be regularly evaluated to identify any unsafe situations or trends. The results of these evaluations should be suitably summarized to give an overall assessment of operating performance. Performance indicators (PIs) of both failures and successes should be utilized. The ISR should review all relevant PIs, which should be subjected to trend analysis to highlight potential safety problems. The licensee can also compare the PIs with other nuclear facilities to benefit from their experiences.
Experience from other similar and dissimilar NPPs, combined with research findings, can occasionally reveal unknown safety weaknesses or can help in solving existing problems. The licensee should have arrangements for assessing information and feedback received as part of its normal activities. The SCA report should include a review of the adequacy of these arrangements and the timely implementation of any findings.
The following elements should be reviewed and verified for effectiveness:
- system for identifying and classifying safety related incidents
- arrangements for root cause analysis of incidents and feedback of results
- methods for selecting, recording, trending and providing feedback for safety related operational data, including those for maintenance, testing and inspection
- systems for formal approval, documentation and modification of procedures
- understanding and acceptance of these procedures by management and on-site staff
- evidence that these procedures are followed
- degree of reliability of assumptions made with respect to licensee actions and findings of the safety analysis, plant design and operating experience
- arrangements for the feedback of experience relevant to safety from similar or other plants
- arrangements for the receipt of information on the findings of relevant research programs
- assessments of -and actions on-the research information
- plant modifications resulting from operating experience and research information gained
2.3.3.1 Performance monitoring and improvement
Performance monitoring and improvement is the process of gathering data and information about the performance of an organization’s activities, analyzing the data, developing and implementing improvement plans, and monitoring the effectiveness of changes intended to bring about the improvements.
Human actions either cause or contribute to majority of events so event analysis should include identification of such causes and contributing factors. This information should be used to make changes to reduce the likelihood of these events occurring in the future.
The following processes should be reviewed and verified for effectiveness:
- identify and record plant conditions
- process to conduct internal performance assessments
- benchmarking activities and their results
- corrective action
- periodic audits
2.3.4 Safety analysis
2.3.4.1 Deterministic safety analysis
The SCA review should update the current safety analysis as necessary to ensure that it is based on the actual plant design, reflects the current state and predicted state of SSC at the end of the review period, and considers all postulated initiating events that are appropriate for the plant design and plant location.
Current, accepted and analytical methods should be used, particularly with regard to computer codes for transient analyses. The assumptions used in these calculations (conservative or best estimate) should be justified with respect to the inherent uncertainties in order to gain greater insight into existing safety margins.
The following elements should be reviewed:
- existing deterministic safety analyses and their assumptions
- limits and permitted operational states
- anticipated operational occurrences
- postulated initiating events (for the existing safety analyses and a comparable list for a modern nuclear facility)
- analytical methods and computer codes used in the existing deterministic safety analyses and comparable methods for a modern nuclear facility, including validation
- radiation doses and limits on radioactive releases for accident conditions
- guidelines for deterministic safety analyses, including guidelines for single failure criterion, redundancy, diversity and separation
The review of the deterministic safety analysis should determine whether the actual plant design is capable of meeting the prescribed regulatory limits for radiation doses and radioactive releases resulting from postulated accidents. It should also identify or confirm any major weaknesses or strengths of the plant design in relation to the application of defence in depth, and should evaluate the importance of systems and measures to prevent or control accidents, with a complete set of postulated initiating events taken into account.
If the safety concept of the plant design differs from current practice, any advantages or disadvantages inherent in that safety concept should be addressed.
The current state of this safety analysis should be reviewed for completeness of the set of postulated initiating events and for its scope, methods and assumptions.
2.3.4.2 Probabilistic safety analysis
The SCA review should update the probabilistic safety analysis (PSA) as necessary to ensure it is valid as a representative model of the plant when the following aspects are taken into account: changes in the design and operation of the plant; new technical information; current methods; and new operational data.
The PSA should include a human reliability assessment (HRA). HRA is a method of estimating the probability of human errors in terms of the probability that a system-required human action, task or job required for safety will not be completed successfully within a required time period. HRA can also consider the probability that extraneous tasks or actions detrimental to system reliability or availability will be performed.
The results of a PSA should be compared with the probabilistic safety criteria (for example for system reliability, core damage and releases of radioactive material) when they have been defined for the facility.
The PSA should be kept sufficiently up to date during the plant lifetime to make it useful in the decision-making process. The PSA should be used to identify opportunities for future improvements by revealing weaknesses in the plant design and operation.
The accident management program for beyond design basis accidents should be reviewed. It should be determined whether the program is suitable for preventing severe core damage or to mitigating its consequences.
The following should be addressed in the review:
- existing PSA and its assumptions
- updating of the PSA to reflect current facility status
- postulated initiating events (for the existing PSA and a comparable list for a modern nuclear facility)
- analytical methods and computer codes used in the existing PSA and comparable methods for a modern nuclear facility, including validation
- guidelines for the PSA of operator action, common cause events, cross-link effects, redundancy and diversity
- consistency of the accident management program for beyond design basis accidents with PSA results
2.3.4.3 Hazard analysis
The review should confirm adequate protection of the NPP against internal and external hazards and should consider the actual plant design, site characteristics, condition of SSC and their predicted state at the end of the period covered by the PSA, and current analytical methods, safety standards and knowledge. The review should establish a list of internal and external hazards that could affect plant safety, taking into account plant design, the condition of SSC and site characteristics. The licensee should also consider changes in plant design, climate, flood potential, and transport and industrial activities near the facility site.
The following analyses should be addressed:
internal hazards such as fire (prevention and suppression), flooding, pipe whip, missiles, steam release, spray, toxic gas, explosion and crane movements
external hazards such as changes in site characteristics, flooding and tsunami, high winds, temperature extremes, seismic hazards, aircraft crash, toxic gas and explosion
for relevant hazards, the review should use current analytical techniques and data to demonstrate either that the probability or consequences of the hazard are sufficiently low so no specific protective measures are necessary, or that the preventive and mitigating measures against the hazard are adequate; any deficiencies should be identified
2.3.4.4 Human factors in safety analysis
The licensee should examine the contribution of human error and human reliability in identifying hazards and risks, and also consider human actions during normal and accident conditions in operability studies, failure modes, and effects and hazard analyses.
Industry best practice should be followed in the assessment, analysis and modeling of human actions. Factors that impact on human performance (human factors) should be considered, and validation of human actions should be conducted to ensure that they are achievable. Human actions should be considered consistently across different safety analyses and in system design activities.
The review of human factors in safety analysis should include:
- systematic method of task analysis and human error identification
- integration of human errors within the safety analysis
- robust, proven, and systematic human error quantification method
- documentation of the analysis
- appropriate representation of human errors in the safety analysis according to risk
- consideration of limitations of methods and techniques
2.3.5 Physical design
The objective of the review of the design of the nuclear power plant is to determine the adequacy of the design and its documentation in an assessment against current international standards and practices.
The review of the plant design should confirm the list of SSC that can directly or indirectly have an adverse effect on the safe operation of the NPP is complete and comprehensive. The review of the plant design should be subdivided into review topics by systems and/or subject matter areas, such as:
- reactor core
- shutdown systems
- primary coolant system
- secondary systems
- containment system
- emergency heat removal, instrumentation and control systems
- electrical power systems
- water supply systems
- fire protection
- human factors in design
- protection against postulated pipe rupture.
The review of the plant design should identify the differences in plant design in an assessment against current safety standards (including relevant design codes) and determine their safety significance (strengths or weaknesses) in relation to the application of defence in depth. The licensee should ensure that the plant configurations and conditions assumed in the safety case reflect the actual plant state. Adequate design information, including information on the design basis, should be available to provide for the safe operation and maintenance of the plant and to facilitate plant modifications.
The SCA review for plant design should include:
- detailed description of the plant design, supported by drawings of the layout, system and equipment
- list of SSC that can, directly or indirectly, have an adverse effect on the safe operation of the NPP and their safety classification
- documented design basis (original and updated)
- significant differences (strengths and weaknesses) between the present plant design and the modern standards and practices (used for comparison)
- safety significance of the identified findings relating to the application of defence in depth
For some older plants, documentation relating to the safety of the design basis will not have been supplied in full to the operator at the commissioning stage. The SCA report should ensure that all significant documentation relating to the original design basis has been obtained, securely stored, and updated to reflect all the modifications made to the plant and procedures since its commissioning.
2.3.5.1 Human factors in design
Human factors (HF) are factors that influence human performance as it relates to the safety of a nuclear facility or activity over all phases, including design, operation, maintenance, and decommissioning. Factors may include the characteristics of the person, task, equipment, organization, environment, and training. It encompasses overall facility layout and design (for example, access and the physical working environment), the design of the workstations and work areas both in control areas and field locations, and the design of specific human-machine interfaces that have the potential to impact safety (for example, control panels, computer-based displays, alarms, and tools).
The licensee should consider any changes made to the design of facilities, systems, or equipment, and then ensure that the impact upon other areas such as training and procedures is determined and addressed. There should be a systematic process for effectively incorporating human factors considerations into system requirements, definition, analysis, design, verification, and validation activities. This process should be carried out by suitably trained, and qualified, specialists.
The review of human factors in design should confirm:
- timely HF inputs as required
- appropriate level of HF effort and expertise
- use of applicable modern codes and standards
- systematically addressing human factors for all plant areas, for all operational scenarios throughout the lifecycle of the plant/system
- verification and validation of human factors and human performance aspects
- appropriate documentation for planning, analysis, verification and validation, and integration into design documentation
G-276, Human Factors Engineering Program Plans [18] and G-278, Human Factors Verification and Validation Plans describe CNSC staff’s expectations of human factors engineering program plans and human factors verification and validation plans, for Class I nuclear facilities and uranium mines and mills, respectively. Expectations for human factors in long-term operation projects are contained in RD-337, Design of New Nuclear Power Plants [19].
2.3.6 Fitness for service
2.3.6.1 Actual condition of SSC
The licensee must determine the actual condition of the SSC of the NPP, including any existing or anticipated obsolescence of plant systems and equipment. This determination should be made at an early stage of the ISR and should then be updated periodically throughout the service life of the NPP or SSC. The process used in carrying out condition assessment of SSC should be documented prior to the start of work. These include, but are not necessarily limited to:
- listing all known and identifying any potential aging degradation processes which could act upon the SSC
- identifying the cause and extent of the degradation on the SSC
- evaluating the current and predicted future effect of the degradation on the functional and performance requirements of the SSC
- identifying means to mitigate aging mechanisms and their effects, such as repairing the SSC to satisfactory condition and preventing further deterioration of the SSC
- providing more frequent inspections of the SSC
- replacing the SSC
- no active intervention
- evaluating the effectiveness of mitigating measures currently in place
- providing recommendations for improvements to existing programs in order to better manage the aging degradation of SSC, including justification for the chosen approach
Existing records should be checked to ensure that they accurately represent the actual condition of the SSC, including any significant findings from ongoing maintenance and inspections. It may not be possible to determine the actual condition of some areas of the plant, owing, for example, to plant layout or operating conditions that preclude a necessary inspection. Such areas should be highlighted and their safety significance considered.
The review of the actual condition assessment of SSC should include:
- a list of SSC that can, directly or indirectly, have an adverse effect on the safe operation of the NPP and their safety classification
- information about the integrity and functional capability of SSC important to safety, including material case histories
- information on the existing or anticipated obsolescence of any SSC important to safety
- findings of tests that demonstrate the functional capability
- results of inspections
- maintenance records
- description of the present condition of SSC important to safety
- description of the support plants available to the plant both on and off the site, including maintenance and repair shops
Having determined the current condition of the SSC important to safety, each of the SSC should then be assessed against its design basis to confirm that aging has not significantly undermined the design basis assumptions. Where consistency with the design basis cannot be fully demonstrated, alternative arrangements should be made to show that the SSC is fit for its purpose and safety margins remain adequate until the end of the proposed LTO, or proposals should be made for corrective actions. This may include additional inspections or, in some cases, component replacements. It may be necessary to use the safety analysis to determine any revised duties or loadings on SSC during normal operation and under accident conditions.
The results of the review of actual condition of SSC should provide information on:
- the current performance and condition of the SSC, including assessment of any aging related failures or indications of significant material degradation, previously unidentified aging mechanisms or effects, and comparisons against predictions for the aging mechanisms and acceptance criteria
- estimation of future performance, aging degradation, and residual service life, where feasible, of the SSC (i.e., the length of time the SSC is likely to meet its function and performance requirements)
- the effectiveness of the aging management programs (AMP) in place for future plant operation
- recommended follow-up or prevention, monitoring, and mitigation measures to be completed and/or incorporated into the AMP, including appropriate intervals for follow-on condition assessments and areas for further research and development
Where measured data is unavailable, the assessment of an SSC should be based on its safety significance and derived from other reliable resources, such as industry reports and special tests or inspections.
2.3.6.2 Equipment qualification
Plant equipment important to safety should be properly qualified to ensure its capability to perform its safety functions under postulated service conditions, including those arising from internal and external events and accidents (such as loss of coolant accidents, high energy line breaks, seismic or other vibration conditions, flooding, fires) in a manner consistent with the safety classification. A qualification procedure should be used to confirm that the equipment is capable of meeting, throughout its service life, the requirements for performing safety functions while subject to the environmental conditions (vibration, temperature, pressure, jet impingement, irradiation, corrosive atmosphere and humidity) prevailing at the time of need, with the aging degradation of the equipment that occurs during service taken into account.
Qualification of plant equipment important to safety should be achieved through a process that includes generating, documenting, and maintaining evidence that equipment can perform its safety functions during its installed service life. This should be an ongoing process, from the plant design to the end of service life; plant aging, modifications, repairs and refurbishment, equipment failures and replacements, and abnormal operating conditions should be taken into account.
Although many parties (such as plant designers, equipment manufacturers, and consultants) are involved in the equipment qualification process, the licensee has the ultimate responsibility for the development and implementation of a plant specific equipment qualification program that includes generating and maintaining the documentation demonstrating qualification.
The review of equipment qualification should include:
- list of equipment covered by the equipment qualification program and a list of control procedure
- qualification report and other supporting documents (for example equipment qualification specifications and qualification plan)
- verification that the installed equipment matches the qualified equipment
- procedures to maintain qualification throughout the installed service life of the equipment
- mechanisms for ensuring compliance with these procedures
- a surveillance program and a feedback procedure to ensure that aging degradation of qualified equipment remains insignificant
- monitoring of actual environmental conditions and identification of ‘hot spots’ of high activity
- analysis of the effects of equipment failures on equipment qualification and appropriate corrective actions and/or safety improvements to maintain equipment qualification
- protection of qualified equipment from adverse environmental conditions
- physical condition and functionality of qualified equipment (to be confirmed by walk downs)
- records of all qualification measures taken during the installed service life of the equipment
The review of equipment qualification should determine: (a) whether assurance of the required equipment performance capability was initially provided and (b) whether equipment performance has been preserved by ongoing application of measures such as scheduled maintenance, testing, and calibration, and has been clearly documented. It should be noted that a review relating to (a) above may not be necessary if a previous review has concluded that adequate initial equipment qualification was established and a review relating to (b) above should provide assurance that equipment qualification will be satisfactorily preserved in future. A plant walk down of installed equipment should be performed to identify for qualified equipment any differences from the qualified configuration (abnormal conditions such as missing or loose bolts and covers, exposed wiring, or damaged flexible conduits).
2.3.6.3 Aging management
All SSC of nuclear plants are subject to some form of physical changes caused by aging, which can eventually impair their safety function and service lifetime. The rates of these changes vary considerably. Special attention should be paid to cases of prolonged construction and extended shutdown. Aging of all materials (including consumables, such as lubricants) and SSC that could impair their safety functions should be understood and controlled. Managing aging for nuclear power plants means ensuring the availability of required safety functions throughout the service life of the plant (including period of LTO), with account taken of changes that occur with time and use.
Whereas the review of the actual condition of the SSC establishes the condition of the SSC at the time of the ISR, the SCA aging management is primarily concerned with the programs and arrangements in place to ensure condition of the SSC in the future. The SCA review of aging management should be conducted in accordance with RD-334, Aging Management of Nuclear Power Plants [20] and IAEA Safety Report Series No. 57 Safe Long Term Operation of Nuclear Power Plants. It should determine whether a systematic and integrated aging management program framework is in place and effective, whether adequate arrangements have been made to fulfill required safety functions during future plant operation, and whether there are any features that would limit plant life. Both programmatic aspects (for example, procedures, performance indicators, staffing) and technical aspects of aging management (for example, understanding of relevant aging phenomena, SSC specific acceptance criteria, aging detection and mitigation methods) should be evaluated.
The review of aging management should confirm a systematic and comprehensive aging management program framework is in place for the facility. It should also demonstrate:
- all SSC that can, directly or indirectly, have an adverse effect on the safe operation of the NPP are covered by the aging management program
- all SSC that can affect safety are evaluated for the proposed period of LTO
- all significant aging mechanisms have been identified, and there is a thorough understanding of the relevant aging mechanisms and their effects
- models used to predict the evolution and advancement of degradation are supported in accordance with current accepted practices pertaining to age related degradation
- SSC-specific or aging mechanism-specific aging management programs are evaluated against defined attributes and shown to be effective
all safety analyses involving time limited assumptions are validated for the proposed period of long term operation to ensure that the aging effects will be effectively managed (i.e., to demonstrate that the intended function of an SSC will remain within the design safety margins throughout the planned period of long term operation)
The SCA report on aging management should include:
- program policy, organization and resources for aging management
- documented method and criteria for identifying SSC covered by the aging management program
- list of SSC covered by the aging management program and records that provide information in support of the management of aging
- evaluation and documentation of potential aging degradation that may affect the safety functions of SSC
- extent of understanding of dominant aging mechanisms of SSC
- availability of data for assessing aging degradation, including baseline, operating and maintenance history
- effectiveness of operational and maintenance programs in managing aging of replaceable components
- programs for timely detection and mitigation of aging mechanisms and/or aging effects
- acceptance criteria and required safety margins for SSC
- awareness of physical condition of SSC, including actual safety margins, and any features that would limit service life
- the results of the review of aging management to demonstrate that aging effects will continue to be identified and managed for these SSC during the planned period of LTO
2.3.7 Radiation protection
The review of radiation protection should demonstrate:
- the extent that radiation protection has been accounted for in the design and operation of the NPP
- the extent that the operating organization has integrated its radiation protection (RP) program requirements into its management system
- whether the RP program provides adequate protection of workers and the public
The licensee should identify all sources of exposure and evaluate radiation doses that could be received by workers as a result of the operation of the plant. The licensee should provide the information on the design and operational arrangements that have been made to minimize the number and locations of radiation sources and the radiation fields associated with them. A review should be included that identifies areas of high activity and their impact on the safety of the plant and site personnel.
The licensee should demonstrate the design and layout of the reactor facility meets CNSC regulatory expectations for radiation protection as set out in, RD-337 Design of New Nuclear Power Plants and RD/GD-369 Licence Application Guide: Licence to Construct a Nuclear Power Plant.
The review of the RP equipment and instrumentation should confirm that there is adequate radiation monitoring in operational states and accident conditions and, as practicable, beyond design basis accidents. The licensee should review the physical condition of radiation instrumentation and equipment and the NPP’s dependency on obsolescent radiation protection equipment for which no direct substitute is available.
2.3.7.1 Radiation protection program
The licensee should evaluate the following aspects of the RP program:
- aging of all materials and obsolescence of the technology of SSC that could impair their radiological safety functions
- classification of areas and access control, including local rules and information on actual dose rates and contamination levels
- radiation exposure and dose control
- co-operation in establishing operating and maintenance procedures when radiological hazards are anticipated, and providing direct assistance when required
- radiation personal protective equipment
- on-site radiological monitoring and surveys
- personnel dosimetry / dose assessment
- radioactive contamination control
- decontamination of personnel, equipment and structures
- solid radioactive waste and radioactive shipments (or control of dispatch of radioactive materials, including transfers and disposal of solid radioactive waste)
The review of the radiation protection program should confirm that radiation protection requirements are implemented by addressing the generic management system principles in Section 3.3.1 Management System, as they relate to radiation protection, by following relevant national and international standards and guidance, and by good industry practice. The licensee should review the arrangements for each controlled area in response to accidents and malfunctions, to include access to PPE, instrumentation and equipment.
The review should confirm the NPP has an appropriate process for the routine recording and evaluation of safety related operating experience, including:
- radiation protection related incidents, or events and near misses
- replacements of RP equipment due to failures or obsolescence
- radiation doses (to workers, including contractors)
- on-site contamination and radiation levels
- generation of radioactive waste
- compliance with regulatory requirements
Records of radiation doses should be reviewed to determine whether these are within prescribed limits and adequately managed. Although radiation risks need to be considered generically across the ISR, the review of this SCA should specifically consider data on radiation doses and the effectiveness of radiation protection measures. The review of radiation doses needs to consider the types of activity being undertaken. This will provide an indication of the risk posed to plant personnel.
2.3.8 Conventional health and safety
Conventional health and safety influences all aspects of safety in an NPP. The review should establish confidence that there is a safe work environment and examine the status of occupational safety within the plant to determine whether or not the licensee complies with accepted good practices and whether there is any unreasonable contribution to risk from non-radiological hazards. Hazardous waste management is addressed in this review, including the licensee’s control practices.
The following elements should be included in the review:
- oversight of the occupational health and safety program
- housekeeping practices and any related procedures
- the condition and availability of emergency response equipment
- policy and procedure for the identification of hazards (for example, mechanical, chemical) and verification that the procedure is applied
- programs and procedures related to the segregation and containment of hazardous materials
- description of licensee activity for maintenance, availability and use of personal protective equipment
- assurance of compliance as related to applicable labour, building and fire codes
2.3.9 Environmental protection
The scope of the environmental protection review includes programs that identify, control, and monitor all releases of radioactive and hazardous substances, and the effects on the environment from the facility’s licensed activities. In addition, it also includes effluent and environmental monitoring; estimation of the dose to members of the public; radioactive waste management; hazardous waste management; response to unplanned releases; and assessment of environmental protection compliance with regulatory requirements including the environmental elements of the management system.
The following elements should be included in the review:
- the management system policy, programs and procedures that address environmental protection requirements
- the program to determine the environmental baseline characteristics of the site and the surrounding area
- assessment of potential sources of environmental impacts
- characterization of discharges of radioactive and hazardous substances
-
effluent and environmental monitoring program which includes :
- locations of points of release
- maximum quantities and concentrations
- anticipated volume and flow rate of releases of nuclear substances and hazardous substances into the environment, including their physical, chemical and radiological characteristics
- environmental monitoring program for the nuclear and hazardous substance waste management
- measures to control releases of nuclear substances and hazardous substances into the environment
- estimated dose to members of the public
- management system elements for the environmental monitoring program
- measures to comply with dose limits for the public and the implementation of ALARA in the environmental protection program
- evaluation of preventive and control measures
- the positions for, and qualifications, training, and responsibilities of workers responsible for environmental protection
- communication and reporting of the environmental monitoring program results
- proposed program to inform persons living in the vicinity of the site of the general nature and characteristics of the anticipated effects on the environment and the health and safety of persons that may result from the licensed activity
- alarm systems to respond to unplanned releases of effluents from on-site facilities
- measures to identify changes in the use of areas around the site
2.3.10 Emergency management and fire protection
The design and operation of a nuclear power plant should ensure that the release of substances affecting the health of workers and the public are minimized to the extent practicable. Planning for the possibility of such releases is a necessary action, not only by the licensee, but also by local, provincial and national authorities.
The licensee should perform an overall review to verify that the emergency planning at the plant continues to be satisfactory. Emergency plans should be maintained in accordance with current safety analyses, accident mitigation studies, and good practices. Emergency exercises should demonstrate and identify possible gaps in the training of on and off site staff, the required functional capability of equipment (including communication equipment) and the adequacy of planning.
The review should confirm that consideration has been given to significant changes at the nuclear plant site, and in its use, such as organizational changes and changes in the maintenance and storage of emergency equipment, and of industrial, commercial and residential developments around the site.
The following elements should be addressed:
- studies of the mitigation of accident consequences
- strategy and organization for emergencies
- documentation of the emergency plans
- plans and procedures for emergencies
- on-site equipment and facilities for emergencies
- on-site emergency centres
- communications
- emergency training, exercises and records of experience
- interactions of relevant organizations such as the regulatory body, police, fire departments, hospitals, ambulance services, local authorities, public welfare authorities and the information media
- arrangements for regular reviews of emergency plans and procedures
- security arrangements for emergencies
2.3.11 Waste management
The licensee should put in place a waste management plan and a system for keeping a record of all issues related to radioactive waste management. Records of waste quantities, storage, inspections, and transfers should be regularly documented in order to identify any unsafe situations or trends. The results of these records should be suitably summarized to give an overall assessment of the management of radioactive waste during each year of plant operation.
The strategy for managing all wastes should be described in the waste management plan, covering both the short term and where possible, the long term. A waste management plan should include:
- descriptions of the area, procedures, criteria, and instruments that will be used to monitor and segregate wastes into different categories
- estimation of the quantity of waste in each category
- specific plans for reuse, recycle, storage, or disposition of the wastes
- clearance levels for the release of material or equipment
- to the extent possible, a long-term waste management strategy
- cost-benefit analysis
The procedures for the management of waste resulting from normal operations are also important factors. Relevant information on the procedures for the waste management processes should cover classification, minimization, segregation, clearance, handling, volume reduction, treatment, packaging, storage, transportation, and final disposition.
The following elements should be addressed and verified:
- the contents of a waste management plan and waste management processes
- a system for monitoring and classifying waste safety related incidents
- arrangements for analysis of waste safety related incidents
2.3.12 Security
The annual site security plan, prepared and submitted by the licensee, encompasses key areas for review in support of the security safety factor. These areas are verified through the review of security performance via promotion, inspection, and verification activities of the nuclear facility. These activities are conducted in conjunction with performance indicators that are used to assess security performance of a facility, for example, CNSC regulatory documents and guides:
- RD-321, Criteria for Physical Protection Systems and Devices at High-Security Sites (confidential document) [21]
- RD-361, Criteria for Explosive Substance Detection, X-ray Imaging, and Metal Detection Devices at High-Security Sites (confidential document) [22]
- RD-363, Nuclear Security Officer Medical, Physical, and Psychological Fitness [23]
- G-208, Transportation Security Plans for Category I, II or III Nuclear Material [24]
- G-274, Security Programs for Category I or II Nuclear Material or Certain Nuclear Facilities [25]
In addition, the review should confirm the accuracy and completeness of documentation of the facility’s site security plan. CNSC expectations are that the nuclear facility will assess the extent to which it meets the security goals and requirements, address all gaps identified, and provide a clear justification for any exemptions, including any associated with their waste management plants or areas.
The review should include the following elements:
- general security information relating to facility location, applicant’s security policy, legal name, address, contact personnel, and associated telephone numbers
- security organization relating to roles within the facility organization, structure and organization of the nuclear security officer/ nuclear response force service, selection criteria for nuclear security officers/ nuclear response force training, exercises, drills, equipment and vehicles for nuclear security officers/ nuclear response force, and records for the above
- protected and inner areas
- security monitoring room(s), and on-site and off-site communications equipment, systems and procedures
- access and identification systems including the control of identification badges or access cards and use of identification badges or access cards
- access controls including screening for weapons and explosive substances (on entry to a protected area) and screening for Category I, II, and III nuclear material (on exit) from a protected area for vehicles, persons, packages/equipment and access devices and access to information
- security systems, technical devices and equipment
- design and performance characteristics
- maintenance, testing and inspection programs
- contingency plans and procedures
- availability and duties of nuclear security officers/nuclear response force members
- sabotage or attempted acts of theft or sabotage of nuclear material or prescribed information/equipment
- protection arrangements with off-site response forces
- security awareness program
- written commitment to maintain and/or replace aging or obsolete equipment and the licensee’s record of equipment maintenance and replacement
2.3.13 Safeguards
CNSC’s regulatory mandate includes ensuring conformity with measures required to implement Canada’s international obligations under the Treaty on the Non-Proliferation of Nuclear Weapons. Pursuant to the Treaty, Canada has entered into a safeguards agreement with the IAEA. This agreement provides the IAEA with the right and the responsibility to verify that Canada is fulfilling its international commitment on the peaceful use of nuclear energy.
CNSC provides the mechanism for the IAEA to implement the safeguards agreement through the NSCA, and its regulations and facility licences. Essential requirements for the application of IAEA safeguards are stated as specific licence conditions.
The essential requirements on the facility to ensure Canada can continue to meet its international safeguards obligations include:
- timely and accurate provision of reports on nuclear materials
- provision of access and assistance to IAEA inspectors for verification activities
- submission of annual operational information and accurate design information of plant structures, processes and procedures
- development and satisfactory implementation of appropriate facility safeguards procedures
The safeguards review should verify:
- an approved safeguards program is established by the facility to identify safeguards-related responsibilities and to provide appropriate documentation and resources in support of CNSC regulatory requirements
- approved operating procedures provide detailed information on defined operator activities for safeguards implementation at the facility
- all necessary safeguards measures are in place to facilitate compliance with the NSCA and the CNSC’s regulatory documents and licence conditions
- a system of nuclear material accountancy and reporting is established according to CNSC requirements
- the facility has provided, in a timely manner, all required reporting on safeguards related operational information and on design information for plant structures and nuclear material
2.3.14 Packaging and transport
The review should focus on the regulatory requirements as they relate to the transport activities performed. The regulatory requirements should be used as criteria for evaluation purposes for each review element.
The following elements should be reviewed:
- training: the program should state what training is required in relation to the duties to be performed
- packaging: the program should cover the package selection, certification of packages, registration of packages, maintenance, and use
- documentation: the program should incorporate a section on the shipment documentation to be used for the transportation of radioactive materials
- dangerous safety marks: the program should describe how and which dangerous goods safety marks are to be displayed on packages and vehicles
- handling: the program should state how non-fixed contamination of external surfaces of packages and on vehicles is controlled
- reporting requirements: the program should state how dangerous occurrences are reported
- records: the program should include the records keeping requirements for the various sections
2.3.15 Safety and control area reports
The SCA reports contain the licensee’s results for the specific review topics in each SCA. The results of the conformity reviews and the comparison against modern codes, standards, and practices are also included. Any findings are categorized and dispositioned in accordance with the process indicated in section 3.2.5.
Each SCA report is expected to contain a number of standard elements. The overall structure of each report should be: a summary of the review followed by detailed reporting and conclusions. The report should include:
- a statement of the objectives of the review
- description of the scope of the review covered in the report
- clear indication of the type of review conducted: a clause-by-clause review, a high-level review, or a combination thereof, and the rationale for selecting this type of review
- systematic coverage of the expected review elements with detailed analysis of how the licensee addressed expectations to fulfill design and licensing bases, as well as satisfying modern codes and standards set out in the basis document
- supporting figures, tables, graphs, data, and any other design or operational information that would be used to support the licensees arguments
- clear indication of the licensee endorsement of any work done by an outsourced contractor, and whether the licensee has corrected any statements made by the contractor
- enough information to allow CNSC staff to make a regulatory determination based on the information contained in the report, which means that the SCA report must be self-standing and complete
SCA reports should not contain: unsupported personal opinion, conjecture, or claims; the names of any individuals; or criticisms of internal processes, procedures.
The licensee should prepare the ISR safety and control area reports to be as self-contained as practicable, avoiding excessive referencing. Where a standard or practice addresses more than one safety and control area, the results of such reviews should be cross-referenced.
It is preferred that the safety and control area reports are submitted concurrently or in a single package because some safety and control area reports may be needed as input for other reports. For example, the report for fitness for service may be used as input for the reports on physical design and safety analysis.
2.3.16 Integrated safety review final report
The licensee should prepare the ISR final report using the results of SCA reports and the global assessment. The ISR final report addresses the objectives of the ISR and the SCA review topics, and should include the following elements:
- summaries of the SCA reports
- global assessment that is based on the aggregate effect of the findings resulting from all safety and control areas, as well as the results each SCA review, taking the proposed corrective actions and safety improvements into account
- any findings related to the licensing and design bases, and disposition methods for these findings
- strengths, weaknesses, and interface issues from the SCA reports
-
strengths and weaknesses of the facility with respect to fulfilling the safety requirements of defence-in-depth,
particularly any elements relating to the basic safety functions of
- reactivity control
- fuel cooling
- confinement of radioactive materials
- safety significance and risk ranking of all the findings (any key safety issues identified should be addressed as soon as practicable, instead of waiting for the ISR process to be complete)
- mitigation methods, safety improvements, and corrective actions proposed for these findings
- statement of the licensee’s assessment of the overall acceptability of LTO of the NPP

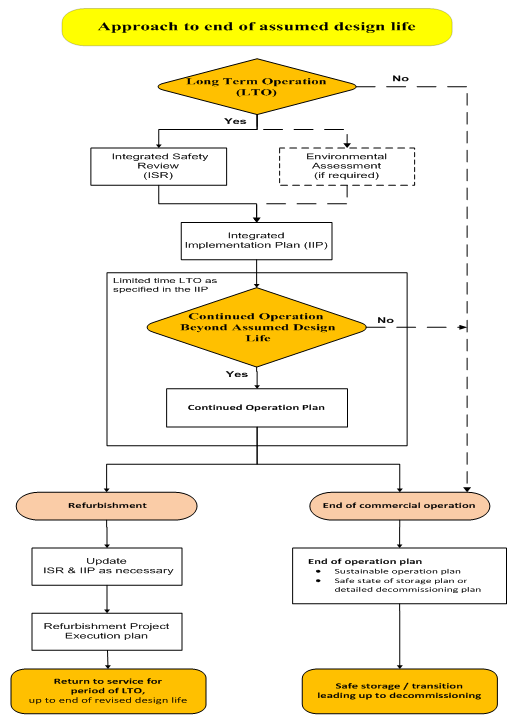

2.4 Integrated implementation plan
The IIP is prepared using:
- ISR final report
- EA (if applicable)
- CNSC staff’s reviews of the SCA reports and ISR final report
The objective of the IIP is to establish as many corrective actions and safety improvements as reasonably practicable. The IIP should include an analysis of the identified short comings and the proposed corrective actions and safety improvements that would address them, to ensure the changes will suit the intended purpose. The method applied in developing corrective actions and safety improvements addressing each of the gaps or grouping of gaps should be described. Corrective actions and safety improvements should be prioritized, and the cost-benefit analysis should be made available as part of the submission where possible.
Another important aspect of the IIP is the inclusion of an implementation schedule for the improvements. Required material and human resources should be specified in this schedule to allow for proper lead time for the acquisition of resources. In the case where the licensee identifies a corrective action or safety improvement that results in a significant safety benefit mid-way through the ISR process, the licensee should implement this change immediately, if possible. Consideration should be given to any interactions between the corrective actions and safety improvements, using appropriate configuration control.
An overview of the acceptability of LTO in view of the proposed changes should be included, to demonstrate the outcome of safety improvements serves the intended purpose of the ISR.
In the IIP the licensee:
- demonstrates traceability and gives references to the ISR final report and EA
- specifies the processes used for determining the detailed scope, including prioritization and scheduling of corrective actions and safety improvements
- provides results, as far as practicable, to support the extended period of operation. The corrective actions and safety improvements address all the ISR and EA results for each safety and control area, and consider the aggregate effect of the gaps in related SCAs
- the schedule for implementation is prioritized on a risk-basis, such that corrective actions and improvements that have the greatest impact on the safety and risk are completed in a timely manner
- specifies processes for identification and management of project risks and controls
- specifies the process to be used to track the progress and completion of the corrective actions and safety improvements
- addresses CNSC approval and licensing requirements
The licensee should have a well-defined process for the control of any changes to the IIP clearly described as part of the proposed IIP. In some cases, approval would be required for the changes, for example:
- changes to the IIP associated with work that is needed to fulfill the requirements identified by the EA
- changes to the IIP for items subject to licence conditions in the PROL
2.5 Continued operation plan
If licensee chooses to operate the NPP beyond the assumed design life for a period less than 10 years, the licensee must prepare a continued operation plan. In this plan the licensee commits to the required corrective actions and improvements that ensure the safe operation of the NPP from the end of assumed design life to the end of LTO. The period of the continued operation plan covers should be stated, and an end of operation date provided. As the continued operation plan is implemented and the end of operation date approaches, the licensee should decide whether to move toward refurbishment or decommissioning.
In the continued operation plan, each SCA should be addressed, describing the depth of the review and results proposed. With these results, the licensee may decide to revise the IIP to narrow the scope to the changes and modifications most applicable to a limited period of LTO. Maintenance of operational fitness of the NPP should be addressed.
The licensee should describe each change, including those related to scheduling, with justifications for any items that have not been dispositioned or have been removed from the original IIP. Any changes to programs, processes or procedures should be described.
2.6 Refurbishment and project execution plan
Significant extension in operation beyond the assumed design life, for more than 10 years, will generally involve major refurbishment activities including:
- replacement of critical SSC (for example pressure tubes, calandria tubes, steam generators, feeders)
- repairs on SSC (for example concrete containment structures, anchors)
- implementation of improvements to the plant (for example improvements related to compliance with modern codes and standards, lessons learned and operational experience) as described in the IIP
The licensee should describe how it will ensure the safe and satisfactory completion of all construction activities during the refurbishment outage, and the return to service activities. All activities carried out during refurbishment should be governed by the provisions of the management system, to ensure that there is controlled turnover of SSC from the construction phase to return to service.
The licensee should also describe the return to service activities, including the commissioning activities, that will confirm that the equipment, SSC, and plant as an integral unit will perform and function in accordance with the design specifications, regulatory requirements, and as credited in the safety analyses.
The plan should address the following:
- provisions made for communication protocol with CNSC staff on all matters related to the plant construction and commissioning activities
- provisions made for making permanent and temporary design changes during construction and commissioning
- provisions made for the identification, resolution and approval of deviations from the design of existing, replace, or new SSC
-
provisions to ensure that changes to the design baseline are identified, reviewed, approved and documented for
the handover of completed work:
- from the construction organization to the commissioning organization
- from the commissioning organization to the operating organization
- provisions to ensure the maintenance of SSC during refurbishment construction activities and commissioning
- provisions for procurement, supply chain, fabrication, on-site fabrication, construction and commissioning
- development, validation and implementation of programs and procedures related to commissioning, reliability testing, maintenance, and operation
- health and safety arrangements made for all activities conducted during construction and commissioning
- security and safeguards arrangements, including access control and access clearance requirements to the construction site
- training and qualification of all staff engaged in construction and commissioning activities
- provisions for the validation at the end of construction, of records that will be transferred to the commissioning or operating organization to be maintained for the lifetime of the installation
Sections following describe more specific expectations regarding the establishment of the safe plant configuration during the refurbishment outage, including modifications to programs and measures in place to ensure safe conduct of the refurbishment activities, and return to service of the plant.
2.6.1 Plant configuration
The licensee should provide the specific plant configuration under which the outage will be carried out. This configuration should take into consideration:
- systems required to remain in operation during the outage
- conditions under which some systems will be laid up
- security requirements
- safeguard requirements
- health and safety requirements, (including radiation safety)
- environmental protection
In cases of multiple unit stations, the following considerations should also be taken into account:
- impact on common facilities and services
- provision for isolation from other units
- impact on the safety case for the nuclear facility as a whole
The licensee should provide a documented case demonstrating that relevant considerations have been taken into account in the establishment of the plant configuration during the outage, and that potential safety impacts have been identified, assessed, and appropriately addressed.
Some changes to the plant configuration may require regulatory approval. These should be clearly identified and included in the licensee submission.
2.6.2 Refurbishment programs and processes
The refurbishment outage includes extensive design, construction, and return to service activities that will be carried out in an unusual plant configuration. It typically involves a large number of workers of various qualifications, performing tasks and working in an environment significantly different from that of an operating plant. In this context, the licensee has to ensure that acceptable programs and processes are in place to address the conduct of the refurbishment outage.
Areas of primary importance include programs and processes related to assurance of adequate engineering design, procurement, construction, worker qualification, worker health and safety, overall plant safety, and assurance of compliance with regulations and international obligations.
Relevant programs and processes include:
- change control
- configuration management
- construction
- commissioning
- corrective actions
- emergency preparedness
- engineering design
- environmental protection
- fire protection
- human factors
- management oversight
- maintenance
- nuclear criticality safety program
- occupational health and safety
- procurement
- quality management
- radiation protection
- safeguards
- safety management
- security
- stakeholder communication
- training and personnel qualification
- waste management
- work control
The licensee should refer to CNSC requirements and appropriate legislation and standards when addressing these considerations, both for guidance in their development, and to determine how program outcomes will be measured.
CNSC staff will assess whether the programs and processes are adequate for the control of the project and that they are being implemented appropriately.
2.6.3 Construction activities
The plan should describe the proposed construction program to be implemented during the refurbishment outage. The plan should demonstrate that the construction program is well planned, controlled and properly documented, and that it adequately covers:
- procurement, construction, fabrication, certification, identification, transportation, and storage
- design and engineering, or testing of SSC, either at the construction site or at fabrication facilities remote from the site
Construction activities should be documented in a controlled construction documentation program that includes construction work plans showing:
- activities to be performed (described in manageable units)
- planned sequential order and duration of these activities
- resource allocation for each activity
- identification, preparation and control of procedures and work instructions
- requirement for special equipment or materials
- inspection or regulatory body hold points
- treatment of environmental considerations
The construction program should also show that the following considerations are addressed:
- description of all necessary functional tests to be carried out, in order to demonstrate that the SSC have been properly manufactured and installed
- confirmation that responsible and competent staff for design, engineering, maintenance, operations and other relevant technical support has been involved in documenting the construction test specifications, including the demonstration that safety objectives have been achieved
- the arrangements in place to ensure that construction and tests are performed in a systematic sequence, from pre-operational tests on each SSC to integrated plant performance tests
- the arrangements made to facilitate regulatory oversight of specified construction stages, tests and/or hold points for specified licensing actions in the construction program
2.6.4 Commissioning program
The licensee should describe the commissioning program that will be implemented. The ultimate objective of commissioning is to demonstrate that the as-refurbished plant performs in accordance with the design intent and the licensing requirements. The commissioning program should be comprehensive, verifiable and detailed in order to provide the necessary assurance that the plant has been duly commissioned before it can be declared in service. The commissioning program should be structured in a systematic sequence so that the plant is exposed to less onerous conditions before more onerous ones with clearly defined commissioning control points to allow assessment and acceptance of the test results before proceeding further.
The commissioning program should address the following considerations:
- description of the technical process to be followed to manage commissioning
- confirmation that tests are to be performed in a systematic sequence from pre-operational tests on each system, structure, and component, to integrated plant performance tests
- description of the verification activities and integrated system validation of the as-built design that are to be carried out, including a description of the human factors verification and validation plan
- confirmation that the program provides for regulatory witnessing of specified tests and/or hold points for specified licensing phases in the commissioning program
- proposal to establish overlaps between commissioning and operations/maintenance procedure development to allow an efficient transfer of knowledge to the operating organization
- proposed arrangements, including timelines and milestones, for the validation of operating procedures (covering normal, abnormal, upset and emergency conditions) that will (to the extent practicable) be carried out as part of the commissioning program and with the participation of the future plant operating personnel
- description of the tests (including acceptance criteria) to be carried out in the different commissioning phases in order to demonstrate that the installed plant meets the design and safety requirements
The commissioning program should provide a case demonstrating the safety of the proposed sequence of commissioning tests.
The commissioning program should be divided into four phases as described below:
- Phase A focuses on ensuring that those systems required to ensure safety with fuel loaded into the reactor have been adequately commissioned. This phase must be successfully completed prior to loading fuel in the reactor
- Phase B focuses on ensuring the fuel is loaded into the reactor safely, confirming that the reactor is in a suitable condition to be started, and that all prerequisites for permitting the reactor to go critical have been met. This phase must be successfully completed prior to removal of the guaranteed shutdown state
- Phase C focuses on confirming reactor behaviour at the stage of initial criticality and subsequent low power tests, and includes activities that cannot be done during the guaranteed shutdown state
- Phase D focuses on demonstrating reactor and systems behaviour at higher power levels, including activities that could not be carried out at the power levels in Phase C
The licensee should describe the return-to-service activities for the facility. Return to service involves returning the nuclear facility, the nuclear systems, and the non-nuclear systems back to commercial operation.
The return-to-service activities should incorporate a set of completion assurance documents for design, construction, and each phase of commissioning. The licensee should ensure that the completion assurance documents:
- describe the modifications to SSC
- demonstrate global completion assurance at each pre-determined milestone
- confirm that training has been provided and a sufficient number of qualified staff is available
Return to service activities should provide a demonstration that all planned activities were completed, that the refurbished plant is compliant with the conditions of the licence and licensing basis, and that the plant can safely return to commercial operation. The licensee should also ensure that operational, engineering, and maintenance documents are available and have been validated to support facility operation.
2.6.4.1 Extent of Commissioning
The extent of commissioning activities described in the commissioning program may be adapted and be commensurate with the scope and duration of refurbishment activities. The commissioning program should provide a case for sufficiency of the scope of commissioning testing both at the individual system level, and for integrated testing of one or multiple systems at the plant.
The extent of commissioning for specific systems should be adapted to the state of the systems during the refurbishment outage and the extent of changes to the systems during the refurbishment. To define the extent of commissioning, the following categories of systems are recommended:
-
SSC in normal operation
- SSC that will remain in normal operation with continued system health and routine maintenance program activities
- commissioning activities could be limited to those checks and tests required to verify that these SSC return to normal service as expected with increased operational loads
-
SSC in shutdown
- SSC that are shut down and placed in a laid-up state
- includes SSC that may have been disconnected or dismantled to provide access to perform work during the outage
- commissioning activities should be defined and be commensurate with SSC-specific refurbishment situations, to ensure operability of the SSC and ensure design and safety analysis assumptions are still met
-
new or modified SSC
- newly installed systems or existing systems that have undergone significant repairs, replacements or modifications
- commissioning should be performed to confirm that the SSC and the integrated plant perform in accordance with the design specifications
The commissioning program should describe the level of necessary commissioning for such systems taking into account the above considerations, and taking into account existing knowledge, aging, and need to re-establish baseline information for future system monitoring.
During refurbishment, extensive design and construction activities are expected to take place involving maintenance, replacement, modification and addition of new SSC. It is expected that the level of commissioning at the facility will demonstrate design and safety analysis assumptions are met. Integrated testing of facility systems should be conducted based on the extent of modifications to the facility and their potential to alter design or safety report assumptions. In the commissioning program, the licensee should describe and justify the adequacy and completeness of the integrated system testing activities.
It is expected that the extent of this testing would be driven by the significance of refurbishment activities. The following need to be considered in the development of the scope of the commissioning program:
-
outage is scheduled or lasts for more than 4 months but less than a year, and three or more of the following SSC
of a NPP are repaired or replaced on a large scale or undergo major design changes
- large pressure vessels
- large pumps
- large heat exchangers
- cooling water structures
- small pumps
- small heat exchangers
- standby generators
- diesel generators
- power and control cables
- instrumentation and control
-
any of the following SSC of a NPP are repaired or replaced on a large scale or undergo major design changes
- fuel channels
- steam generators (including internals)
- reactor assembly/calandria supports
- major civil structures (including containment)
- reactivity mechanisms (including SDS1 and SDS2)
- turbine generator
- station computers
- emergency core cooling and injection systems
- nuclear piping (including feeders)
- outage is scheduled or lasts for more than one year
2.6.4.2 Hold points
The commissioning program should be structured in a systematic sequence so that the plant is exposed to less onerous conditions before more onerous ones with clearly defined hold points before proceeding further. Hold points are imposed to ensure proper assessment of available commissioning results against pre-defined acceptance criteria.
To facilitate the release of hold points, the licensee should develop detailed matrices of the pre-requisites that must be formally demonstrated for prior agreement of all the stakeholders. The commissioning program should describe the formal process used for the release of hold points.
A subset of the hold points will require formal regulatory approval in order to be released. Typically, regulatory hold points will be aligned with commissioning phases, and key commissioning tests or power levels.
CNSC approval to remove a regulatory hold point is contingent on licensee submission of a Completion Assurance Document, which presents evidence that all project commitments scheduled for completion before removal of the respective hold point have been met, that all relevant design, construction, and commissioning completion assurance reports have been completed, and a written confirmation that the plant condition are such that the facility may proceed safely to the next phase of commissioning. The CNSC must accept the Completion Assurance Document before authorization to remove the hold point can be issued.
To facilitate the release of regulatory hold points, it is recommended that the licensee develop detailed matrices of the pre-requisites that must be formally demonstrated for prior agreement of all the stakeholders.
The selection of the hold points will generally be agreed between the licensee and the CNSC and incorporated in the licence.
2.6.5 Return to normal operation
Once all CNSC approvals have been granted and hold points have been removed, the licensee may proceed to normal operation. After return to service, the licensee is expected to monitor the adequacy of performance of the nuclear facility and new or updated programs.
2.6.6 Project monitoring
The licensee is expected to monitor the project for progress, safety, and quality at all phases of execution. All risks that are identified should be appropriately managed.
Monitoring includes (but is not limited to):
- engineering changes
- scope changes
- contractor oversight
- effectiveness of corrective actions
- procedural non-compliances
- nuclear facility configuration
- schedule adherence
- worker safety events involving injuries, near misses, unsafe practices, unplanned dose uptakes
- environmental performance
-
determination of the need to
- create new programs and procedures
- revise existing programs and procedures
- change resources
- revise existing training programs or material
- develop and implement new training programs or material
At the conclusion of the project, the licensee is to ensure that all outstanding commitments have been completed, including any improvements that have been committed for post-restart completion. These items shall be tracked through the normal licensing processes.
3.0 End of Operation Plan
3.1 Sustainable operation plan
The sustainable operation plan (SOP) describes the licensee’s actions to transition the NPP from normal operation to safe state of storage (SSS). The licensee should address the following general elements:
- the date the NPP will transition into SSS and the length of time the reactor will be in SSS
- the management system and any special conditions or changes required during the transition to SSS, period of SSS, transition to decommissioning and decommissioning itself (for example, any particular procurement practices, maintenance programs, quality management)
- maintenance of operational fitness of the NPP leading up to SSS and decommissioning, including assurances that the NPP continues to meet the design and licensing bases, and performing safety analysis to consider the effects of aging on SSC and operational safety margins of the NPP
- retention of experienced, qualified staff and the management of knowledge of the facility and its equipment
- identify the use of contractors and the level of control associated to work carried out by contractors
- training to be provided to workers who will be involved in the SSS as well as decommissioning activities of the NPP
- review environmental releases to be monitored during transition and period of SSS (for example, releases, soil contamination, groundwater contamination)
- changes to any plans due to exceptional circumstance
- how security of the facility will be maintained
- what aging management programs will be required over the SSS period
- how radiation protection will be maintained
- financial guarantees for decommissioning and transition from SSS to decommissioning
3.2 Safe state of storage plan
The purpose of the SSS plan is to verify the licensee’s ability to place and maintain the NPP into a condition of safe long term storage prior to decommissioning. The plan is composed of:
- stabilization activity plan (SAP), which describes the actions to transition from a shut down reactor to SSS
- storage and surveillance plan (SSP), which describes the activities required to maintain safety of NPP while in SSS
At all stages of the preparation and implementation of the SSS plan, it is the licensee’s responsibility to ensure that workers, the public and the environment are well protected from radiological and conventional hazards. Prior to being placed in safe state of storage, measures should be taken to reduce the hazards associated with an NPP to the extent practicable. By utilizing this method the licensee is able to reduce general maintenance needs of the NPP, as well as allow time for decommissioning considerations.
The principle task in developing the SSS plan is a thorough safety assessment, addressing all elements of each SCA authorized by the PROL. This assessment forms the basis of the SAP and the SSP. As the basis for measures to be taken during both the transition into SSS and through the SSS period, the safety assessment should be as comprehensive as possible, considering both radiological and conventional hazards for the entire facility, not just the reactors. This assessment establishes confidence in the licensee’s ability to safely maintain the facility and is the basis of baselines for monitoring, maintenance, surveillance and future dismantling. Dependant upon the period of SSS, it may be beneficial to the licensee to reassess the safety using new measured data at predetermined intervals. This safety assessment and any revisions using new data should be submitted to the CNSC.
3.2.1 Stabilization activity plan
The SAP applies to the NPP as it transitions from normal operation into SSS. This portion covers activities and tasks to be carried out as the NPP is prepared for SSS.
This plan should address all actions and activities required to transition the NPP from a permanent de-powered state to SSS. Activities such as removal of fuel, draining of the moderator, and isolation of residual radioactive sources are undertaken to reduce the radioactive source term are examples of actions included in the SAP. Safety culture and occupational health and safety programs should be reviewed to ensure that workers who will remain on site understand the effects the change to the NPP will have on general safety practices.
As the transition from normal operation to SSS occurs, certain areas of the facility will become more or less restricted due to new or modified hazards. The SAP should review access controls to all areas of the facility during the transition to SSS and throughout the SSS period. Radiation protection is an important consideration during this process because the changing configuration of the facility may induce new radiological hazards not present previously. This review will ensure that worker exposure to hazards are minimized to the extent possible, and where exposure cannot be removed, proper consideration is given to minimize exposure and time at risk.
Site preparation is another aspect of the SAP. The licensee should review all SSC at the facility to identify which will require modification or upgrade to accommodate SSS, and which can be removed from service. Once these are identified, and submitted to the CNSC for review, the licensee can implement the changes in support of SSS.
3.2.2 Storage and surveillance plan
The storage and surveillance plan describes the measures applied to ensure that the facility is kept in a safe condition throughout the SSS. The tasks in this plan are centered on equipment, systems, processes and procedures that require maintenance and the plan states the required frequency of the activities. Frequency of maintenance typically decreases while the facility is in SSS, but the methods used to monitor and maintain equipment should be generally unchanged.
This plan should use existing procedures to the extent practicable to minimize the need for development of new and specific procedures. Some new procedures or programs will be needed due to the nature of special considerations while the NPP is in SSS, such as ground water leakage and inspection of the condition of the structural elements of the facility.
The plan should also describe:
- actions to be taken during normal and abnormal occurrences while the facility is in SSS
- frequency and nature of maintenance, inspection and monitoring activities including aging management programs
- physical security for the NPP while in SSS
- parameters to be monitored to ensure integrity of the NPP (for example humidity, corrosion, ventilation, atmospheric pollutants)
- parameters to be monitored to ensure environmental protection and monitoring of potential effluents and releases
- parameters to be monitored to ensure radiation protection requirements continue to be met for residual staff and the public
- changes to any plan, program or procedure in place required for SSS (for example changes to the emergency plan, RP program)
- resources required for maintenance of the NPP throughout the SSS phase (for example: equipment, capital, personnel, supplies)
- waste management practices to be applied, including predicted levels of waste, sorted by category, generated in each phase covered of SSS
- records to be generated while in SSS
3.3 Decommissioning
When the licensee has put the NPP into SSS, the preliminary decommissioning plan should be updated and a detailed decommissioning plan prepared. The detailed decommissioning plan should be prepared in support of the application for a decommissioning license in accordance with the regulatory guide G-219: Decommissioning Planning for Licensed Activities [26], and CSA N294-09: Decommissioning of Facilities Containing Nuclear Substances [27].
As the license to decommission is separate from the PROL, decommissioning is outside the scope of this document.
Glossary
- assumed design life
-
The period of operation that was originally anticipated at the design phase for the NPP. It is used as a
reference or target for planning activities including the design of SSC that can affect the safe operation of
the NPP.
For the purposes of this regulatory document and for the current operating CANDU power reactors, unless otherwise stated, the “assumed design life” of an NPP is 30 years, based on 0.8 capacity factor of nominal full power, i.e. 210,000 EFPH from the date of its first criticality. For multi-unit NPP facilities, the assumed design life for the facility is based on the date at which the first unit reached first criticality. - codes, standards, and practices
- The information contained in guidance documents and in modern industrial codes, guides, and standards. Practices need to take into account known related design improvements for structures, systems and components as well as operating experience and findings from technical developments (for example, new knowledge on the cumulative effects of aging, results of reactor physics research and development, human factors engineering, human reliability and software engineering). See also “modern codes, standards, and practices”.
- design basis
- The range of conditions and events taken into account in the design of structures, systems, and components of a nuclear facility, according to established criteria, such that the facility can withstand them without exceeding authorized limits for the planned operation of safety systems. The design basis includes the design description, design manuals, design drawings and the safety analysis report.
- EFPH
- Effective full power hour; the period over which a component sees service that equals the amount of full service the component would have experienced if it was operated continuously over a full hour.
- end of operation
- Final, permanent shutdown of reactor operation of an NPP (or unit of a multi-unit NPP facility). The NPP facility remains subject to a power reactor operating licence that authorizes activities during the transition period from reactor unit shutdown and safe state of storage until it enters the decommissioning phase.
- finding
- A piece of information obtained or a conclusion reached when specific statements or actual conditions are compared with what is required, expected, accepted or practiced.
- generic safety issues
- Unresolved safety-related issues, common to all NPP designs, requiring that corrective actions be taken by the licensees within a reasonable time frame.
- global assessment methodology
- A methodology or means of formulating an overall risk judgment on the acceptability of continued safe operation of the nuclear facility for the proposed period of life extension.
- integrated implementation plan (IIP)
- A plan that considers the technical scope and schedule of the project to support operation beyond assumed design life by taking into account the results of an environmental assessment (EA), where required, and an Integrated Safety Review (ISR).
- integrated safety review (ISR)
- A comprehensive assessment of nuclear facility design and operation that deals with the cumulative effects of aging, modifications, operating experience, technical developments and siting aspects, and aims at ensuring a high level of safety throughout the operating life of the facility (or activity).
- integrated safety review (ISR) basis document
- The information that sets out the scope and methodology for the conduct of the ISR.
- long-term operation (LTO)
- The operation beyond the assumed design life of the NPP, which has been justified by the results of an integrated safety review taking into consideration the conditions of structures, systems, and components (SSC), life limiting processes, and a review of the plant design and operational measures in place against modern codes and practices.
- licensing basis
- For a regulated facility or activity, a set of requirements and documents comprising:
- regulatory requirements set out in the applicable laws and regulations
- conditions and safety and control measures described in the facility’s or activity’s licence and the documents directly referenced in that licence
- safety and control measures described in the licence application and the documents needed to support that licence application
- modern codes, standards, and practices
- The set of objectives, requirements, and experience for the siting, design, construction, commissioning, operation, and decommissioning of a nuclear facility if it were to be built at the time of the initiation of the project to support long-term operation.
- nuclear facility
- For the purposes of this document, a nuclear power plant; it includes, where applicable, the land on which the reactor is located, a building that forms part of or equipment used in conjunction with the reactor, and any system for the management, storage, or disposal of a nuclear substance.
- refurbishment
- An activity or a set of activities aimed at restoring the condition of one or several structures, systems, or components to a state that is comparable to the condition of a new structure, system, or component.
- safety case
- An integrated collection of arguments and evidence to demonstrate the safety of the facility and that all applicable regulatory requirements are met. This will normally include a safety assessment, but could also typically include information (including supporting evidence and reasoning) on the robustness and reliability of the safety assessment and the assumptions made therein.
- safety goal
- Objective to protect reactor facility staff, the public and the environment from harm by establishing and maintaining effective defences against the release of the radiological hazards.
- safety significance
- The significance of a discovery or issue with respect to the impact on meeting the fundamental nuclear safety objectives as defined by the IAEA 1 . In general, a discovery or event has safety significance if it denotes a deviation away from the safety case accepted in the licence, in a direction detrimental to safety, such as:
- reducing margins to, or exceeding the accepted limits
- increasing risk
- impairments (various degrees) of the special safety systems or of the safety functions for accident mitigation
- human factor issues
- events causing radioactive releases and spills of hazardous substances, injuries to workers, public
- structures, systems and components (SSC)
- A general term encompassing all of the elements (items) of a facility or activity that contributes to protection and safety, except human factors. Structures are the passive elements: buildings, vessels, shielding. A system comprises several components, assembled in such a way as to perform a specific (active) function. A component is a discrete element of a system. Examples are wires, transistors, integrated circuits, motors, relays, solenoids, pipes, fittings, pumps, tanks, and valves.
- storage with surveillance
- A planned stage during a decommissioning program during which the remaining nuclear substances, equipment, and site(s) are placed under controlled surveillance for a specified period of time. Note: Licensing control by the regulatory authority remains in effect during such periods.
- time-limited assumptions (TLA)
- Assumptions used in certain plant- or SSC-specific safety or design analyses that are based on an explicitly specified length of plant or SSC life; for example, metal fatigue calculation, pressurized thermal shock (PTS) analysis, radiation-induced deformation and embrittlement, thermal aging, loss of material and equipment qualification of electrical and I&C cables are included in the analyses.
Appendix A: Life Management of Nuclear Power Plants
Appendix B: Technical Content Guidelines: Sufficiency Checks
Completeness |
Comprehensiveness |
Correctness |
Appropriateness |
a. The objectives and scope of the submission are clearly stated. b. The subject-matters are explicitly and unambiguously described in the submission. c. The requirements and expectations of all applicable acts, regulations, regulatory documents, codes and standards, as well as CNSC and IAEA guidance documents are identified. d. OPEX and industry best practices, where applicable, are considered. e. Where applicable, conformance of plant state with current codes and standards is included (as opposed to comparing current with old versions of codes and standards). |
a. All elements, aspects and activities related to the subject matters expected to be addressed are covered. (That is, is the submission self-standing?) b. Licensee’s level of demonstration of conformance/compliance is substantiated by rationale, justifications, discussions or evidence contained in the submission, to a depth sufficient to allow CNSC staff to make regulatory determination. c. The rationale, justifications, discussions, and evidence given in the submission are structured, organized and auditable. d. The submission has been subject to a formal approval process indicating the licensee has assumed accountability for the technical integrity and accuracy. |
a. The requirements and expectations of all applicable acts, regulations, regulatory documents, codes and standards, as well as CNSC and IAEA guidance documents are correctly interpreted and applied. b. The approach and methodology are in conformance with applicable requirements. c. Supporting analyses are performed in conformance with applicable standards and industry best practices. b. Assumptions and premises used in the submission are consistent with the stated objectives and scope and are justified. c. Rationale, justifications and other statements in the submission are supported by specific and agreed codes, standards and practices, as well as relevant research and development results, and licensee’s documents. d. Statements in the submission are substantiated by credible reference material; verified by recognized experts or established best practice; and likely to gain the approval of an independent subject-matter-expert. |
a. Relevant requirements and expectations of all applicable acts, regulations, regulatory documents, codes and standards, as well as CNSC and IAEA guidance documents are used and met. b. Materials, methods or resources used (references, recognized experts or established best practices) are relevant, current and known by subject-matter-experts in the field. c. The content of the submission addresses and focuses on meeting the stated objective(s) and scope. d. Approach, methods, processes, procedures and programs used in the submission are relevant, proven by practice, or, where applicable, accepted by the CNSC. e. Conclusions and recommended actions are consistent and commensurate with licensee’s existing commitments, obligations or concurrent activities. f. Conclusions are consistent with the objectives and scope of the submission and are consistent with, and supported by, the information stated throughout the submission. |
Appendix C: CNSC Safety and Control Areas
Functional Area |
Safety and Control Areas |
Specific Areas |
Management |
Management System |
n management system (including safety management) / quality management oversight n organizational structure, roles and responsibilities, resource management, leadership n strategic/business planning n internal communications n monitoring and review of safety management performance n organizational / change management n management of safety issues (including R&D programs) n safety culture |
Human Performance Management |
n personnel training n personnel examination and certification (where required) n work organization and job design (minimum shift complement, hours of work limitation) n human performance programs (procedural adherence, event free tool, identification of error) n fitness for duty n procedures and job aids (development and validation) |
|
Operating Performance |
n conduct of licensed activity n adequacy of procedures n operating experience (corrective actions programs, root cause analysis, effectiveness review) n reporting and trending n outage management performance |
|
Facility and Equipment |
Safety Analysis |
n deterministic safety analysis n hazard analysis (internal and external) including n fire hazard analysis n seismic hazard assessments n flood hazard n safe operating envelope n probabilistic safety analysis (including human reliability analysis) n robustness analysis n criticality safety |
Physical Design |
n system classification n site characterization n engineering change control n equipment qualification n facility safety systems n reactor control systems n human factors in design n configuration management n pressure boundary design n fuel design n nuclear design n process and control systems n waste management systems n electrical and distribution systems n environmental qualification and control systems n instrumentation and control systems (including software) n emergency and service water systems n cables n device and package certification n master equipment list |
|
Fitness for Service |
n equipment fitness for service/equipment performance (for example, system health report) n maintenance (including outage management process) n reliability n structural integrity n life cycle management n aging management n chemistry control n condition monitoring |
|
Core Control Processes |
Radiation Protection |
n application of ALARA n dosimetry services n worker dose control n contamination control |
Conventional Health and Safety |
n compliance with applicable labour code n house keeping (fire, chemical, tripping hazard) |
|
Environmental Protection |
n effluent and emissions control (releases) n environmental monitoring n estimated dose to public n environmental risk assessment n environmental management system |
|
Emergency Management and Fire Protection |
n nuclear emergency management n fire protection and response n conventional emergency response n business continuity |
|
Waste Management |
n waste minimization, segregation and characterization n waste storage and processing n preliminary decommissioning plans |
|
Security |
n facility security n material security n security systems n cyber security |
|
Safeguards |
||
Packaging and Transport |
n adherence to CNSC, Transport Canada, and international regulations on packaging and transport |
1 IAEA, INSAG 12, Basic Safety Principles for Nuclear Power Plants 75-INSAG-3 Rev. 1, Vienna, 1999.
References
- Canadian Nuclear Safety Commission (CNSC), RD-360 version 2, Life Management of Nuclear Power Plants (draft).
- Canadian Environmental Assessment Act (CEAA), S.C. 1992, c. 37.
- CEAA, Comprehensive Study List Regulations, SOR/94-638.
- CEAA, Exclusion List Regulations, SOR/2007-108.
- CEAA, Inclusion List Regulations, SOR/94-637.
- CEAA, Law List Regulations, SOR/94-636.
- CEAA, Procedures for an Assessment by a Review Panel, guidelines issues pursuant to the Act, November 1997.
- Government of Canada, Canada Labour Code, Part II, Occupational Health and Safety, R.S., 1985, c. L-2, 2009.
- Canadian Environmental Assessment Agency, Operational Policy Statement, Preparing Project Descriptions under the Canadian Environmental Assessment Act, 2000.
- International Atomic Energy Agency (IAEA), Safety Reports Series No. 57, Safe Long Term Operation of Nuclear Power Plants, 2008
- IAEA, Periodic Safety Review of Nuclear Power Plants—Safety Guide, Safety Standards Series No. NS-G-2.10, Vienna, 2003.
- Canadian Environmental Assessment Agency, Operational Policy Statement, Preparing Project Descriptions under the Canadian Environmental Assessment Act, 2000.
- Canadian Standards Association (CSA), N286-05 Management System Requirements for Nuclear Power Plants. Mississauga, 2005.
- International Organization for Standardization, ISO 14001:2004, Environmental Management Systems, Geneva, 2004.
- British Standards Institution, Occupational Health and Safety Assessment Series (OHSAS) 18001:2007, Occupational Health and Safety Management Systems – Requirements, London, 2007.
- CNSC, G-323, Ensuring the Presence of Sufficient Qualified Staff at Class I Nuclear Facilities - Minimum Staff Complement , 2007.
- CNSC, G-278, Human Factors Verification and Validation Plans, 2003.
- CNSC, G-276, Human Factors Engineering Program Plans, 2003.
- CNSC, RD-337, Design of New Nuclear Power Plants, 2008.
- CNSC, RD-334, Aging Management for Nuclear Power Plants (draft).
- CNSC, RD-321, Criteria for Physical Protection Systems and Devices at High-Security Sites (confidential document), 2010.
- CNSC, RD-361, Criteria for Explosive Substance Detection, X-ray Imaging, and Metal Detection Devices at High-Security Sites (confidential document), 2010.
- CNSC, RD-363, Nuclear Security Officer Medical, Physical, and Psychological Fitness, 2008.
- CNSC, G-208, Transportation Security Plans for Category I, II or III Nuclear Material, 2003.
- CNSC, G-274, Security Programs for Category I or II Nuclear Material or Certain Nuclear Facilities, 2003.
- CNSC, G-219, Les plans de déclassement de a
- CSA N294-09 Decommissioning of Facilities Containing Nuclear Substances, Mississauga, 2009.
Additional Information
The following documents contain additional information that may be of interest to persons involved in long term operation of a nuclear facility:
- Access to Information Act, R.S.C. 1985, c. A-1.
- Canada Water Act, R.S.C. 1985, c. C-11.
- Canadian Environmental Protection Act, S.C. 1999, c. 33.
- Canadian Nuclear Safety Commission (CNSC), INFO-0774 Environmental Assessment Screening Process at CNSC, Ottawa, Ontario, Canada, January 2009.
- CNSC, P-242, Considering Cost-benefit Information, Ottawa, Ontario, Canada, 2000.
- CNSC, S-99, Reporting Requirements for Operating Nuclear Power Plants, Ottawa, Ontario, Canada, 2003.
- CNSC, G-206, Financial Guarantees for the Decommissioning of Licensed Activities, Ottawa, 2000.
- CNSC, G-320 Accessing the Long Term Safety of Radioactive Waste Management, Ottawa, 2006.
- Fisheries Act, R.S.C. 1985, c. F-14.
- International Atomic Energy Agency (IAEA), Maintenance, Surveillance and In-service Inspection in Nuclear Power Plants, Safety Standards Series, Safety Guide NS-G-2.6, Vienna, 2002.
- IAEA, Ageing Management for Nuclear Power Plants, Safety Standards Series, Safety Guide NS-G-2.12, Vienna, 2009.
- Migratory Birds Convention Act, S.C. 1994, c. 22.
- Nuclear Fuel Waste Act, S.C. 2002, c. 23.
Page details
- Date modified:
